AI Implementation Strategy in Business Anyone can open a chatbot and get a decent answer in ten seconds. Getting that same AI to show up reliably inside your support inbox, your CRM, or your billing process is a different problem entirely.

That gap between experimenting with AI and actually running it as part of your business is where most companies get stuck. This guide is written for US small and mid-size businesses, and it walks through use-case selection, readiness, data, tools, people, governance, revenue opportunities, and ongoing measurement.

U.S. Chamber of Commerce data shows generative AI use among small firms jumped from 23% in 2023 to 40% in 2024 to 58% in 2025. The tools are spreading fast. The question is whether your business can turn that adoption into a process that holds up under real volume.

Key Takeaways

  • AI implementation changes workflows, technology, data, and people together, not just software.
  • Start with one valuable problem and a measured baseline before you pick a tool.
  • Clean data, human oversight, and employee buy-in matter more than the model you choose.
  • Compare buying, integrating, and building based on fit, cost, and who owns the result.

What AI Implementation Means for a Business

AI implementation is the process of identifying a business problem, selecting or building an AI capability, folding it into daily work, training employees to use it, and watching its performance over time. Treat it as a sequence of decisions, not one purchase. Those decisions touch three connected layers:

  • Technology and infrastructure — the tools, APIs, and systems the AI runs on
  • Data and governance — what information feeds the system and who controls it
  • People and workflows — who uses the tool, and whether the process actually changes

Experiment, Pilot, or Production Capability?

These three stages get conflated constantly, and that's part of why implementations stall.

  1. Experiment — someone tries a chatbot or tool informally, with no defined owner or success measure
  2. Pilot — a scoped test with real users, a limited workflow, and a go/no-go decision point
  3. Production capability — a repeatable process embedded in daily operations, with a named owner and ongoing monitoring

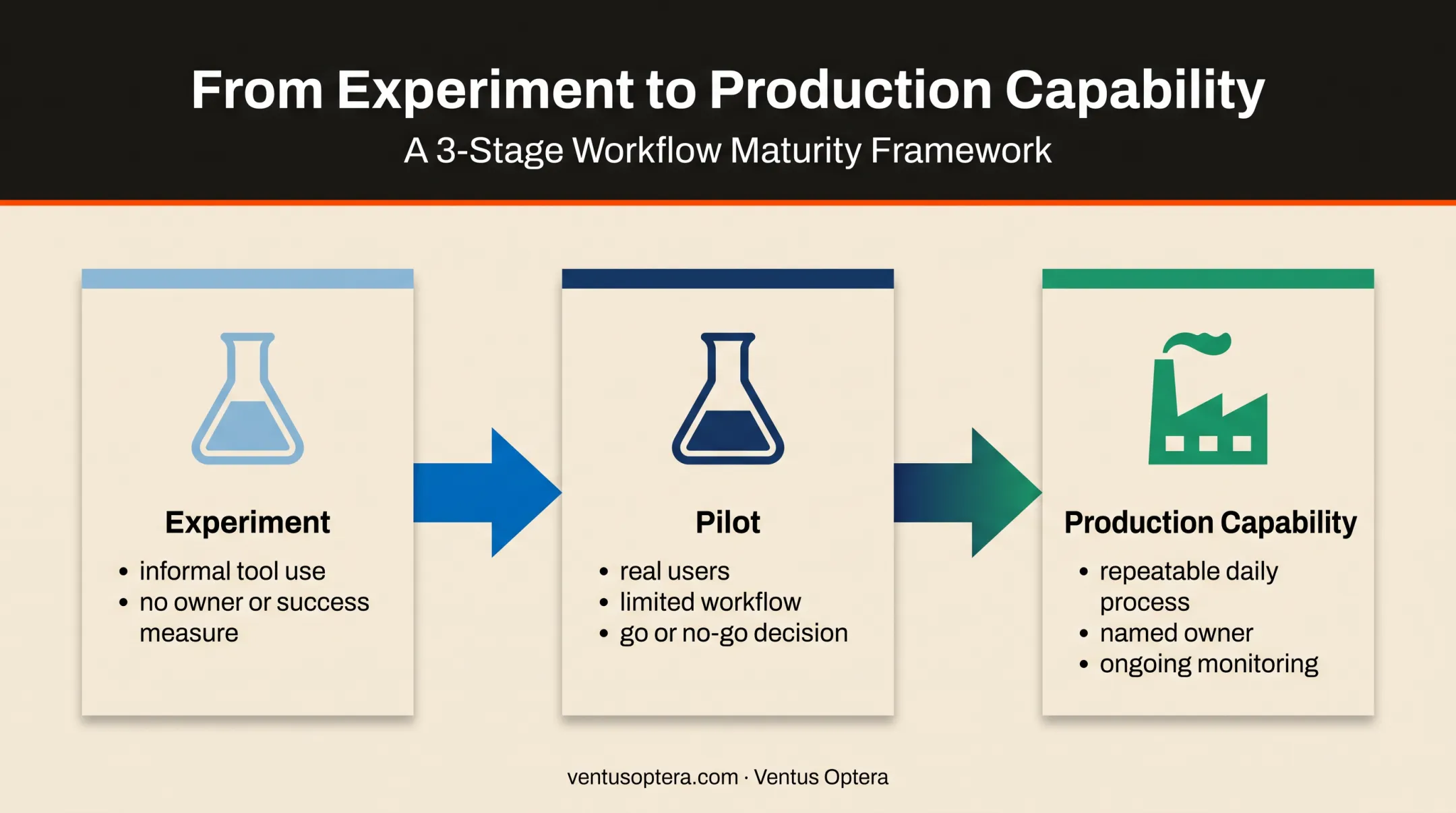

Three-stage AI implementation maturity model from experiment to production

Ventus Optera's engagements follow this progression directly. An Audit or AI Opportunity Assessment maps current work. A Sea Trial or Build stage produces a tested prototype against agreed pass/fail criteria. An Automate stage adds AI tooling with staff training before handover. Each stage has a defined deliverable instead of an open-ended tool rollout.

What Good Implementation Actually Delivers

Done well, AI implementation reduces repetitive work, speeds up customer response, and connects systems that currently don't talk to each other. The Intuit QuickBooks survey of more than 2,200 US small businesses found 68% reported regular AI use, and among users, 74% said it made them more productive, mostly in marketing, customer service, and administrative tasks.

That's a self-reported productivity signal, not a controlled study. In practice it shows up as fewer hours lost to manual lookups, faster first responses, and teams spending more time on judgment calls instead of data entry.

Building an AI Implementation Strategy

Most failed AI projects start with a tool, not a problem. Flip that order.

Start With the Business Outcome

Before evaluating any vendor, identify one of these:

  • An expensive delay (slow quote turnaround, slow support response)
  • A repetitive task eating staff hours
  • A quality problem (errors, inconsistent output)
  • A customer-friction point (confusing onboarding, slow follow-up)
  • A recurring decision your team makes the same way, over and over

Define a measurable objective and record a baseline before you touch a tool. If you don't know your current average response time, you can't prove the AI improved it.

Assess Readiness Honestly

Readiness isn't just "do we have a budget." Check these dimensions:

  • Data availability and quality: is it current, accessible, and accurate?
  • Current software and integrations: will a new tool talk to what you already have?
  • Security and privacy requirements: what data can the tool actually touch?
  • Employee skills and process ownership: who will run this day to day?
  • Leadership support: will this survive a budget review in six months?

NIST's AI Risk Management Framework warns that datasets can go stale relative to how they're actually deployed, and recommends testing under conditions that resemble real use rather than ideal conditions. Use that as a gut check. If your test data looks nothing like your messiest real ticket queue, pilot results won't mean much once you scale (NIST AI RMF 1.0, 2023).

Prioritize With Value Versus Effort

Rank candidate use cases on:

  • Expected business impact
  • Implementation complexity
  • Data access
  • Risk level
  • Time to value
  • Realistic employee adoption

Boston Consulting Group frames this as pairing high-payoff initiatives with smaller efforts that deliver benefits sooner. Treat it as a prioritization habit, not a fixed formula.

Buy, Integrate, or Build

Path Best fit Trade-off
Buy an AI-enabled product Common workflows, fast deployment Licensing cost, vendor dependence
Integrate existing systems via API You already have the core tools Integration complexity, maintenance
Build a targeted custom workflow Workflow doesn't fit generic tools Higher upfront cost, full ownership

This is where an AI opportunity assessment earns its keep. Ventus Optera's version maps current work such as quoting, intake, scheduling, and support, finds where hours go, and ranks fixes by ROI and risk. Each fix is tagged as build, buy, or process change.

For a Boston nonprofit sailing school, that kind of review covered 16 platforms and sorted each into keep, merge, or replace, rather than defaulting to "buy something new."

The fit is specific: businesses that have outgrown spreadsheets and generic tools but don't need a full enterprise transformation. Clients keep ownership of the software and data built for them, so a custom tool does not lock you into one vendor indefinitely.

Choosing Business Use Cases and Revenue Opportunities

AI use cases cluster by function. Here's where most SMBs find traction:

  • Customer service and support — ticket triage, instant answers, escalation routing
  • Sales and CRM — lead scoring, follow-up reminders, account visibility
  • Marketing — content drafts, SEO, email personalization
  • Finance and billing — invoice matching, anomaly flags
  • Operations — scheduling, inventory signals
  • Internal knowledge — searchable documentation, onboarding materials
  • Reporting and workflow automation — dashboards that answer recurring questions automatically

Revenue Comes From Fixing What's Already Broken First

Before chasing speculative new revenue, tighten what's already in motion:

  • Cut response delays that lose deals
  • Flag expansion opportunities inside existing accounts
  • Improve onboarding so new customers stick
  • Surface churn risk before a customer leaves quietly

A documented example: Hospitable, a San Francisco software company, used Intercom's Fin chatbot against its support knowledge base, escalating anything it couldn't handle to a person.

The vendor reported 500 backlogged queries cleared immediately, 30% of inbound questions resolved automatically, and 95% faster response times, per Intercom's Hospitable case study. That's a vendor-reported result for one company, not an industry average. Treat it as a directional example, not a guarantee.

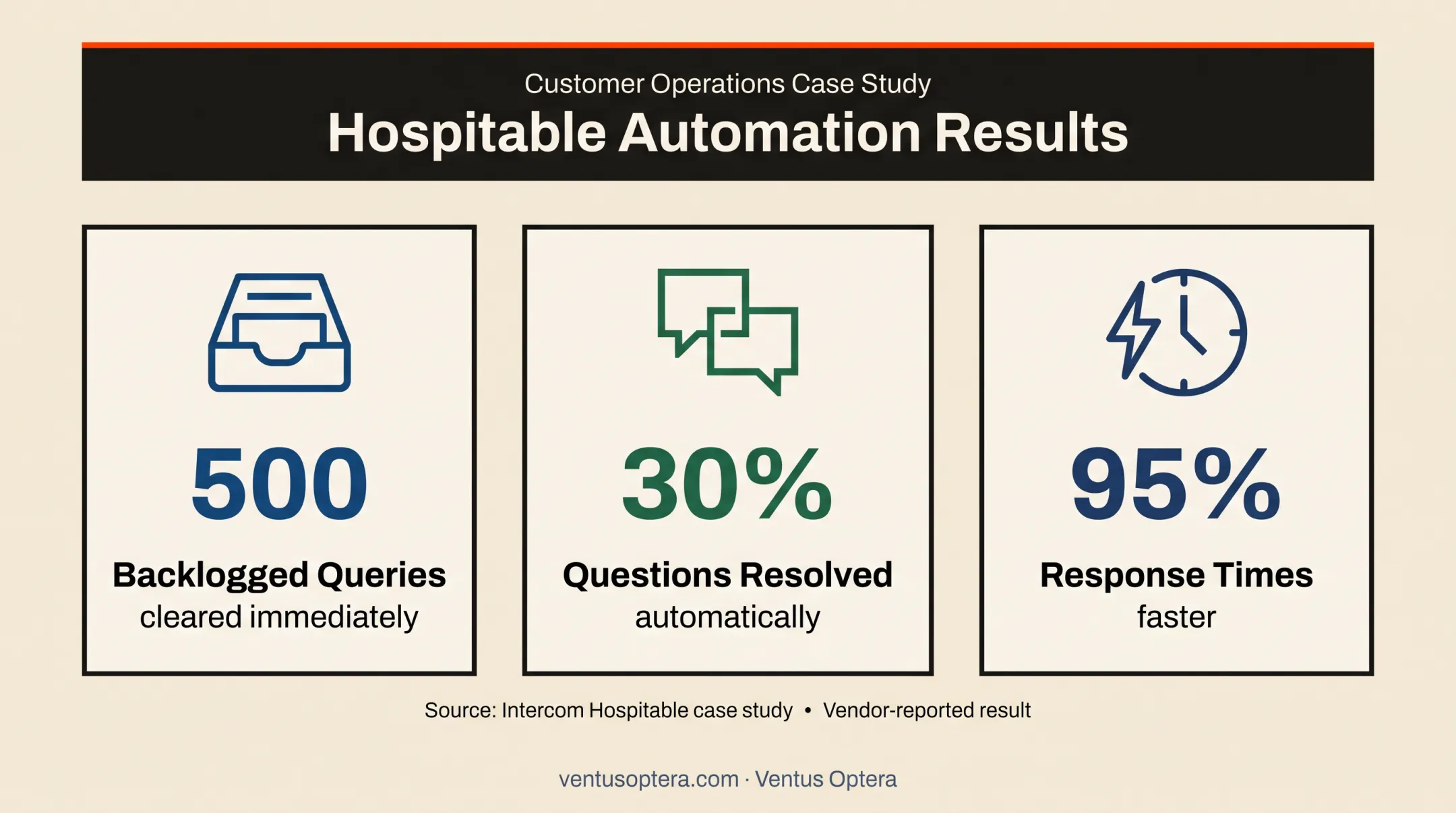

Hospitable AI support chatbot results showing response and workload improvements

Client work shows the same pattern. An onboarding rebuild for Sheprd produced 3x new bookings and doubled rebookings.

During Uber's 2014–2017 investigations and triage work, better analytics and a redesigned escalation process cut time-to-solve on critical security issues in half. Those gains came from process redesign paired with the right tooling, not the tool alone.

Run Every Use Case Through This Test

Before committing to any AI use case, answer:

  1. What process actually changes?
  2. Who owns it after launch?
  3. What data does it need, and do you have it?
  4. What human review stays in place?
  5. Which metric — cost, revenue, quality, speed, or satisfaction — proves it worked?

A Fragmented Workflow, Made Whole

Picture a company where CRM updates, ad account data, support tickets, contracts, and billing terms all live in different tools, updated by different people, on different schedules. Nobody has one view of a client relationship.

That's exactly the gap Ventus Optera closed for a cybersecurity firm. Signed contracts, billing terms, and change history were scattered across inboxes, shared drives, and spreadsheets.

Moving all of it into one client-account system, covering 31 accounts and hundreds of contacts at rollout, gave the team one place to see what was in force and what had changed. No AI model required for that fix. Just one dashboard replacing five disconnected sources.

AI Governance and Common Implementation Challenges

Governance sounds like a compliance exercise until the first incident happens. Then it's the thing that determines whether your business has a defensible answer.

What Governance Actually Covers

  • Privacy and data retention policies
  • Access controls and role-based permissions
  • Confidential information handling
  • Vendor terms (what happens to your data once it's in their system)
  • Auditability of AI-generated decisions
  • Bias and hallucination risk
  • Required human approval points

The FTC has made clear that AI tools aren't exempt from existing rules against deception or unfair practices. Its Operation AI Comply named five enforcement actions tied to deceptive AI claims. (FTC, 2024)

If your industry touches employment decisions, the EEOC has said existing federal antidiscrimination law still applies when AI helps screen applicants or evaluate performance. A neutral-looking tool can still create disparate impact. If you're in California or Colorado, check current compliance dates for automated decision-making rules; they've shifted more than once in the past two years.

Why Implementations Fail

The same failure patterns repeat across companies:

  • Unclear objectives from the start
  • Poor or duplicated data
  • Disconnected systems that don't share information
  • Employee resistance to changed workflows
  • Buying too many overlapping tools
  • No single person accountable for performance
  • Scaling a pilot before it's actually reliable

Practical Safeguards Worth Putting in Writing

  • Approved-use policies for employees
  • Role-based access, checked on every request
  • Documented prompts and workflows (not tribal knowledge)
  • Human review of outputs before they go external
  • Testing against representative data, not cherry-picked samples
  • A clear escalation path when the AI gets it wrong
  • One named person accountable for results

Those controls only work when someone designs them before launch. Boston Dynamics' Support Center work is a high-bar example: Salesforce, Jira, Paligo, and Docebo connected under ITAR export controls, with publishing rules so public users, customers, and partners only see content they're entitled to see. Most small businesses don't need ITAR-grade controls, but the habit does apply everywhere: decide who sees what before a mistake forces the issue.

The 30% Rule and 10/20/70 Rule, With Proper Context

Two heuristics show up constantly in AI planning decks, and both get misquoted.

The 10/20/70 rule comes from BCG's 2019 research: roughly 10% of AI value from algorithms, 20% from technology, and 70% from business-process transformation. BCG's 2024 update reframes it as 10% algorithms, 20% technology and data, 70% people and processes. (BCG, 2019) Either version makes the same point: the model is the easy part.

The 30% rule has no single verified origin. A widely circulated Forbes Technology Council version (Marco Costa) suggests AI handles roughly 70% of a task and humans finish the remaining 30%.

That figure is not Gartner's separate 2024 forecast that at least 30% of generative AI projects would be abandoned after proof of concept by the end of 2025. Treat both percentages as directional, not as budget formulas.

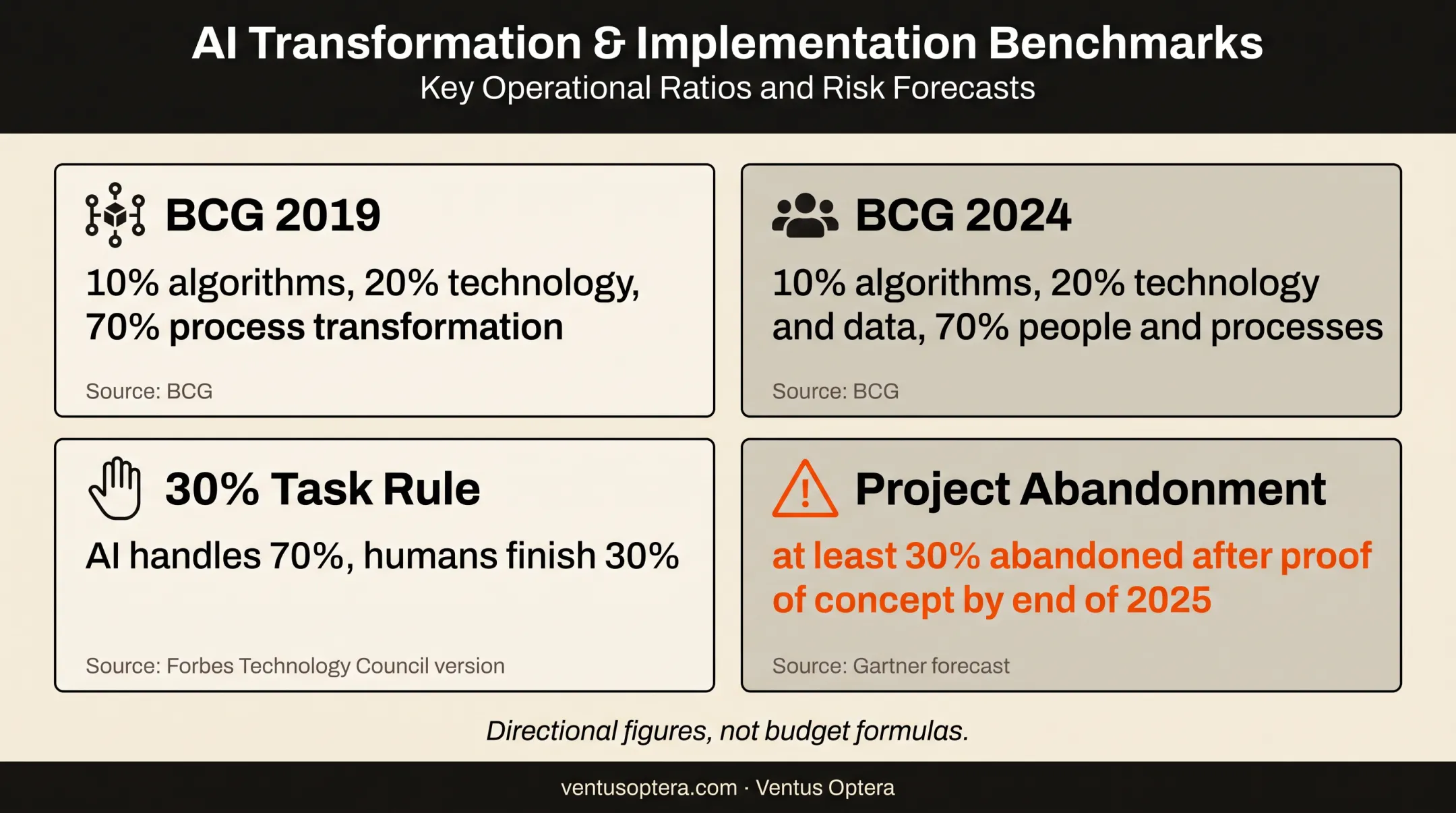

AI implementation rules comparing value allocation and human task completion

Measuring, Scaling, and Continuously Improving AI

A pilot without a defined metric isn't a pilot. It's an extended experiment with no exit criteria.

Define Success Before Launch

Pick metrics tied directly to your use case:

  • Cycle time or response time
  • Error or escalation rate
  • Cost per task
  • Conversion or retention rate
  • Customer satisfaction score
  • Adoption rate among employees
  • Revenue contribution

Record the baseline first. NIST's framework is explicit here: document test sets, metrics, and evaluation methods, and test under conditions that resemble actual deployment — not a clean demo environment.

Run a Constrained Pilot

  1. Define a small user group, not the whole company
  2. Limit scope to one process, not five
  3. Use representative test data, including messy edge cases
  4. Keep human review in place, especially early on
  5. Collect feedback continuously, not only at the end
  6. Set a written go/no-go decision point before you start

Build an Operating Rhythm After Launch

Once live, the work isn't done:

  • Monitor quality and usage weekly or monthly
  • Review exceptions the AI couldn't handle
  • Watch for data or model drift as conditions change
  • Revisit the original business case periodically to confirm it still holds

NIST flags model and data drift specifically as a trigger for corrective maintenance, not a one-time setup concern.

Scale Without Creating Another Island

The biggest scaling mistake: turning one proven workflow into a second disconnected system instead of extending the first one properly. Before scaling, confirm you have:

  • Documentation someone besides the original builder can follow
  • Working integrations, not manual workarounds
  • Clear ownership and permissions
  • A support plan for when something breaks
  • Portability — can you take this system to a new vendor if needed?

Those requirements are why fixed-scope pilots work better than open-ended builds. Ventus Optera's Sea Trial ships a tested prototype against pass/fail criteria in about four weeks, with a written go, no-go, or fix recommendation.

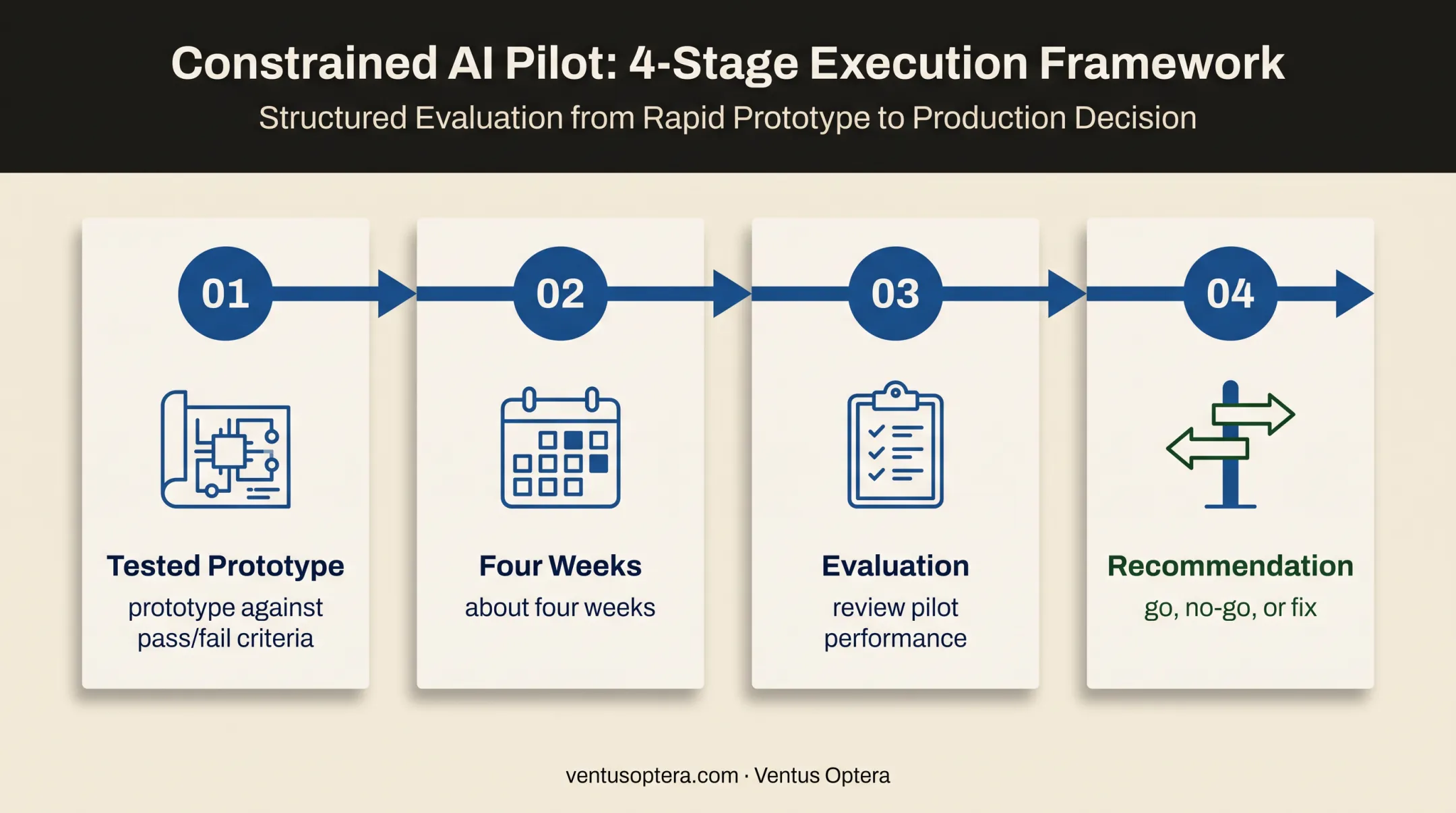

Four-week AI pilot delivery timeline with pass-fail decision outcomes

For teams that need AI-enabled workflows, dashboards, or CRM integrations without replacing their full stack, that structure keeps the system documented, owned, and ready to extend—not another island to maintain.

Frequently Asked Questions

What are the key components of an AI implementation plan for business?

A solid plan covers objectives, readiness, data quality, ownership, technology choice, governance, a pilot with clear success criteria, and ongoing measurement. Skipping any one is usually where projects stall.

How is AI being implemented in business?

Businesses pick a specific use case, prepare the data and workflow, select or build a solution, pilot it with human oversight, then integrate and monitor. Sequence matters more than the tool.

How can businesses use AI to generate revenue?

Revenue gains usually come from faster lead handling, personalized outreach, stronger retention, and better account visibility, plus occasional AI-enabled products. Validate claims against a baseline metric, not vendor marketing.

What is the 30% rule for AI?

There's no single verified source for a universal "30% rule." A common version says AI handles about 70% of a task and humans the remaining 30%, but that's an illustration, not a validated standard.

What is the 10/20/70 rule for AI?

BCG's research describes AI value as roughly 10% algorithms, 20% technology, and 70% process and people change. It's a planning heuristic meant to be adapted to context, not a fixed spending formula.
